Operational Forecast Cycling¶
Operational forecast cycling is the process of running a hydraulic model repeatedly as new forecast data arrives, typically updating every 6 hours as HRRR (High-Resolution Rapid Refresh) weather model cycles are released.
This notebook demonstrates how to use ras-commander to automate this workflow:
- Download successive HRRR forecast cycles
- Update HEC-RAS plan simulation dates to match each forecast window
- Execute the model for each cycle with force_rerun=True
- Archive results by cycle for comparison
- Compare how forecasts evolve as new data arrives
This pattern is common in flood forecasting operations, emergency management support, and real-time hydrologic monitoring.
Series position: Read this after 915_realtime_forecast_workflow.ipynb and 918_hms_ras_coupled_forecast.ipynb. It assumes the forecast workflow and HMS-RAS handoff pattern are understood, then focuses on repeatedly executing and archiving cycles.
# =============================================================================
# DEVELOPMENT MODE TOGGLE
# =============================================================================
USE_LOCAL_SOURCE = True # <-- TOGGLE THIS
if USE_LOCAL_SOURCE:
import sys
from pathlib import Path
local_path = str(Path.cwd().parent)
if local_path not in sys.path:
sys.path.insert(0, local_path)
print(f"LOCAL SOURCE MODE: Loading from {local_path}/ras_commander")
else:
print("PIP PACKAGE MODE: Loading installed ras-commander")
import ras_commander
print(f"Loaded: {ras_commander.__file__}")
LOCAL SOURCE MODE: Loading from <workspace>/ras_commander
Loaded: <workspace>\ras_commander\__init__.py
from pathlib import Path
import pandas as pd
import numpy as np
import matplotlib.pyplot as plt
from datetime import datetime, timedelta
from ras_commander.precip import PrecipHrrr
from ras_commander.boundaries import CoastalBoundary
from ras_commander import init_ras_project, RasExamples, RasPlan, RasCmdr
plt.style.use("seaborn-v0_8-whitegrid")
pd.set_option("display.precision", 2)
What You'll Learn¶
- Set up a forecast cycling configuration for multiple HRRR cycles
- Update HEC-RAS plan simulation dates to match each forecast window using
RasPlan.update_simulation_date() - Use
force_rerun=TruewithRasCmdr.compute_plan()to ensure fresh execution each cycle - Handle data availability and latency in an operational setting
- Archive results by cycle for audit trails and comparison
- Compare sequential forecasts to assess convergence and uncertainty
Example 1: Retrospective Forecast Cycling With Hydrologic Evidence¶
This example uses four deterministic forecast cycles for the same flood event window. Each cycle represents a new forecast issued six hours apart, with the later cycles converging toward the final event timing and rainfall depth.
The point of the demonstration is not just that the automation loop runs. It shows the operational question an engineer actually cares about: do successive forecast cycles change the predicted crest, flood-threshold exceedance, and timing enough to change an emergency-management decision?
The precipitation and response functions below are self-contained so the notebook executes without downloading gigabytes of HRRR GRIB2 files. The same cycle metadata is passed to the ras-commander execution template later in the notebook, where a project-specific workflow would write DSS or inline boundary data, call RasPlan.update_simulation_date(), and execute RasCmdr.compute_plan(..., force_rerun=True).
Configuration¶
# Forecast cycling configuration for a Bald Eagle Creek style riverine basin.
# These values keep the notebook deterministic while preserving realistic units
# and decision thresholds an operational forecaster would review.
config = {
"project_path": "/path/to/ras_project",
"ras_version": "6.6",
"plan_number": "01",
"forecast_hours": 36,
"basin_name": "Bald Eagle Creek demonstration basin",
"basin_bounds": (-77.9, 40.8, -77.3, 41.1),
"decision_point": "Bald Eagle Creek at Lock Haven forecast point",
"stage_datum": "ft, local HEC-RAS project datum",
"drainage_area_sqmi": 105.0,
"runoff_coefficient": 0.42,
"time_of_concentration_hr": 5.5,
"baseflow_cfs": 650.0,
"action_stage_ft": 14.0,
"flood_stage_ft": 17.0,
"major_flood_stage_ft": 21.0,
"archive_dir": Path("forecast_archive"),
}
base_time = datetime(2024, 7, 15, 0)
valid_times = pd.date_range(base_time, periods=config["forecast_hours"] + 1, freq="1h")
forecast_hours = np.arange(len(valid_times))
cycles = [
{"date": "20240715", "cycle": 0, "label": "00z early", "total_in": 3.55, "center_hr": 18.5, "spread_hr": 5.8, "burst_in": 0.35},
{"date": "20240715", "cycle": 6, "label": "06z update", "total_in": 4.20, "center_hr": 16.5, "spread_hr": 5.0, "burst_in": 0.55},
{"date": "20240715", "cycle": 12, "label": "12z update", "total_in": 4.85, "center_hr": 15.2, "spread_hr": 4.2, "burst_in": 0.85},
{"date": "20240715", "cycle": 18, "label": "18z latest", "total_in": 4.65, "center_hr": 15.0, "spread_hr": 4.4, "burst_in": 0.78},
]
print("Forecast Cycling Configuration")
print("=" * 72)
print(f"Basin: {config['basin_name']}")
print(f"Drainage area: {config['drainage_area_sqmi']:.1f} sq mi")
print(f"Decision point: {config['decision_point']}")
print(f"Stage datum: {config['stage_datum']}")
print(f"Forecast window: {valid_times[0]:%Y-%m-%d %H:%M} to {valid_times[-1]:%Y-%m-%d %H:%M}")
print(f"Action/flood/major stage thresholds: {config['action_stage_ft']:.1f}, {config['flood_stage_ft']:.1f}, {config['major_flood_stage_ft']:.1f} ft")
print()
print("Forecast cycles:")
for cycle in cycles:
cycle_start = datetime.strptime(cycle["date"], "%Y%m%d").replace(hour=cycle["cycle"])
print(
f" {cycle['label']:<11} issued {cycle_start:%Y-%m-%d %HZ}: "
f"{cycle['total_in']:.2f} in basin rainfall, center at hour {cycle['center_hr']:.1f}"
)
Forecast Cycling Configuration
========================================================================
Basin: Bald Eagle Creek demonstration basin
Drainage area: 105.0 sq mi
Decision point: Bald Eagle Creek at Lock Haven forecast point
Stage datum: ft, local HEC-RAS project datum
Forecast window: 2024-07-15 00:00 to 2024-07-16 12:00
Action/flood/major stage thresholds: 14.0, 17.0, 21.0 ft
Forecast cycles:
00z early issued 2024-07-15 00Z: 3.55 in basin rainfall, center at hour 18.5
06z update issued 2024-07-15 06Z: 4.20 in basin rainfall, center at hour 16.5
12z update issued 2024-07-15 12Z: 4.85 in basin rainfall, center at hour 15.2
18z latest issued 2024-07-15 18Z: 4.65 in basin rainfall, center at hour 15.0
Compute Forecast Hydrology and RAS-Ready Cycle Metadata¶
The following cells turn each forecast cycle into basin-average precipitation, a routed inflow hydrograph, and a stage response. In a production deployment, the same per-cycle loop is where ras-commander would write DSS/inline boundary data and execute the corresponding HEC-RAS plan.
def forecast_hyetograph(hours, total_in, center_hr, spread_hr, burst_in):
"""Create a smooth basin-average QPF hyetograph in inches/hour."""
hours = np.asarray(hours, dtype=float)
broad = np.exp(-0.5 * ((hours - center_hr) / spread_hr) ** 2)
burst = np.exp(-0.5 * ((hours - (center_hr - 2.0)) / 1.35) ** 2)
intensity = broad + burst_in * burst
intensity = intensity / intensity.sum() * total_in
return intensity
def unit_hydrograph(hours, tc_hr):
"""Dimensionless unit hydrograph used for a compact routing demonstration."""
t = np.asarray(hours, dtype=float)
shape = 3.2
scale = max(tc_hr / shape, 0.1)
uh = (t + 0.1) ** (shape - 1) * np.exp(-(t + 0.1) / scale)
uh = uh / uh.sum()
return uh
def route_to_flow(precip_in_hr, config):
"""Convert basin-average rainfall to an outlet hydrograph in cfs."""
effective_rain = precip_in_hr * config["runoff_coefficient"]
uh = unit_hydrograph(np.arange(len(precip_in_hr)), config["time_of_concentration_hr"])
runoff_in_hr = np.convolve(effective_rain, uh, mode="full")[: len(precip_in_hr)]
cfs_per_in_hr_sqmi = 645.33
return config["baseflow_cfs"] + runoff_in_hr * config["drainage_area_sqmi"] * cfs_per_in_hr_sqmi
def stage_from_flow(flow_cfs):
"""Simple monotonic rating curve for demonstration-stage response."""
return 5.5 + 0.128 * np.sqrt(np.asarray(flow_cfs, dtype=float))
cycle_frames = []
summary_rows = []
for index, cycle in enumerate(cycles, start=1):
precip = forecast_hyetograph(
forecast_hours,
total_in=cycle["total_in"],
center_hr=cycle["center_hr"],
spread_hr=cycle["spread_hr"],
burst_in=cycle["burst_in"],
)
flow = route_to_flow(precip, config)
stage = stage_from_flow(flow)
cycle_start = datetime.strptime(cycle["date"], "%Y%m%d").replace(hour=cycle["cycle"])
cycle_label = f"{cycle['date']}_{cycle['cycle']:02d}z"
cycle_dir = config["archive_dir"] / cycle_label
frame = pd.DataFrame(
{
"valid_time": valid_times,
"forecast_hour": forecast_hours,
"cycle_label": cycle["label"],
"cycle_id": cycle_label,
"issue_time": cycle_start,
"precip_in_hr": precip,
"cumulative_precip_in": np.cumsum(precip),
"flow_cfs": flow,
"stage_ft": stage,
}
)
cycle_frames.append(frame)
peak_idx = int(np.argmax(stage))
flood_mask = stage >= config["flood_stage_ft"]
summary_rows.append(
{
"cycle": index,
"cycle_id": cycle_label,
"label": cycle["label"],
"issue_time": cycle_start,
"total_precip_in": precip.sum(),
"peak_flow_cfs": flow.max(),
"peak_stage_ft": stage.max(),
"crest_time": valid_times[peak_idx],
"hours_above_flood": float(flood_mask.sum()),
"archive_dir": str(cycle_dir),
"ras_status": "RAS-ready metadata generated",
}
)
forecast_df = pd.concat(cycle_frames, ignore_index=True)
summary_df = pd.DataFrame(summary_rows)
latest_peak = summary_df.iloc[-1]["peak_stage_ft"]
summary_df["peak_stage_delta_vs_latest_ft"] = summary_df["peak_stage_ft"] - latest_peak
summary_df["crest_time_delta_vs_latest_hr"] = (
summary_df["crest_time"] - summary_df.iloc[-1]["crest_time"]
).dt.total_seconds() / 3600
print("Cycle processing summary")
print("=" * 72)
display(
summary_df[
[
"cycle",
"label",
"total_precip_in",
"peak_flow_cfs",
"peak_stage_ft",
"crest_time",
"hours_above_flood",
"peak_stage_delta_vs_latest_ft",
"crest_time_delta_vs_latest_hr",
"ras_status",
]
]
)
Cycle processing summary
========================================================================
| cycle | label | total_precip_in | peak_flow_cfs | peak_stage_ft | crest_time | hours_above_flood | peak_stage_delta_vs_latest_ft | crest_time_delta_vs_latest_hr | ras_status | |
|---|---|---|---|---|---|---|---|---|---|---|
| 0 | 1 | 00z early | 3.55 | 7125.52 | 16.30 | 2024-07-15 22:00:00 | 0.0 | -2.88 | 4.0 | RAS-ready metadata generated |
| 1 | 2 | 06z update | 4.20 | 9420.80 | 17.92 | 2024-07-15 20:00:00 | 6.0 | -1.26 | 2.0 | RAS-ready metadata generated |
| 2 | 3 | 12z update | 4.85 | 12302.97 | 19.70 | 2024-07-15 19:00:00 | 9.0 | 0.51 | 1.0 | RAS-ready metadata generated |
| 3 | 4 | 18z latest | 4.65 | 11427.52 | 19.18 | 2024-07-15 18:00:00 | 9.0 | 0.00 | 0.0 | RAS-ready metadata generated |
Hydrologic and Hydraulic Forecast Evidence¶

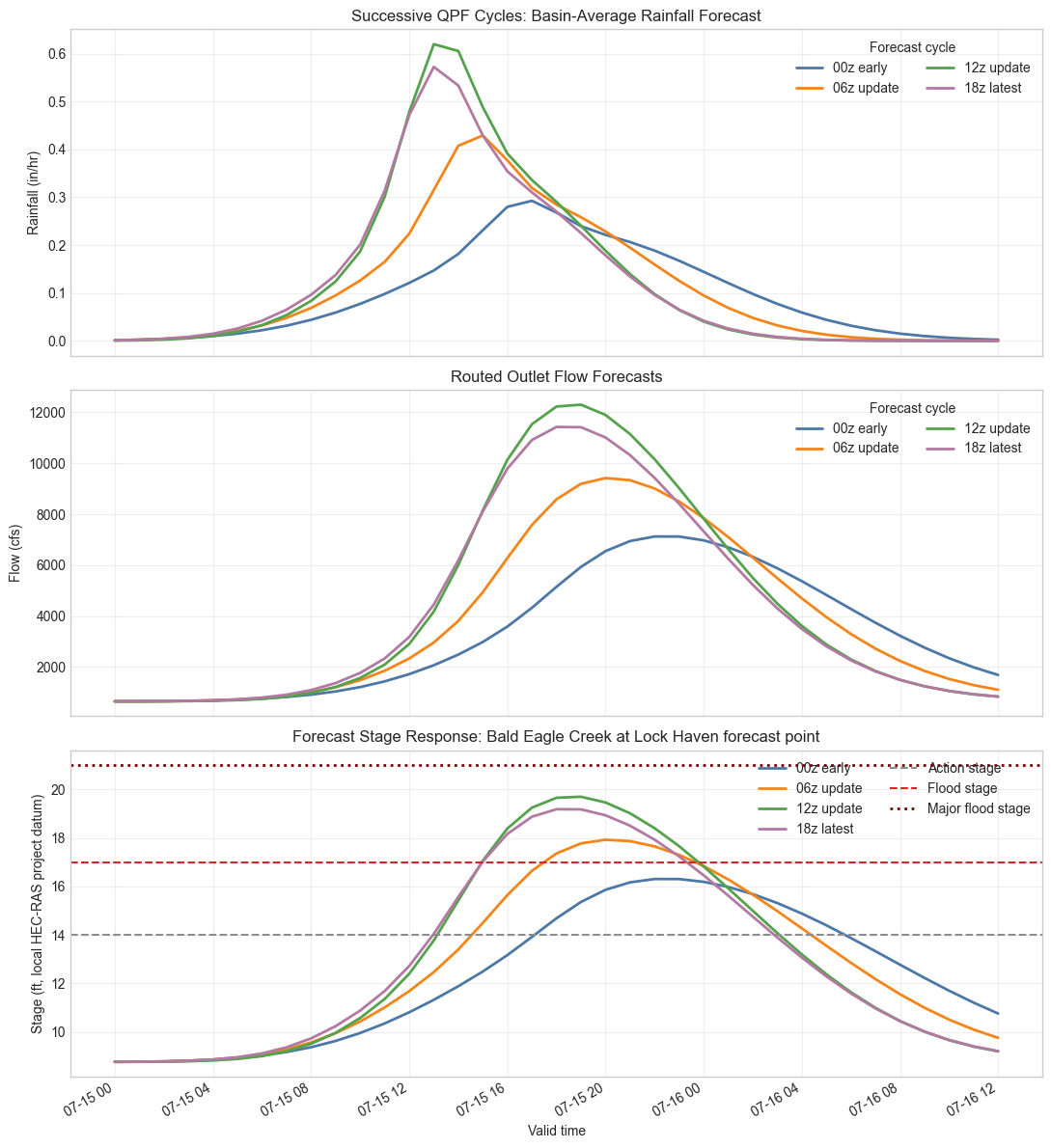

These figures show why forecast cycling matters operationally: each cycle changes the rainfall volume/timing, which changes the routed flow hydrograph, stage crest, threshold exceedance duration, and confidence in the latest forecast.
colors = {
"00z early": "#4C78A8",
"06z update": "#F58518",
"12z update": "#54A24B",
"18z latest": "#B279A2",
}
fig, axes = plt.subplots(3, 1, figsize=(11, 12), sharex=True)
for label, group in forecast_df.groupby("cycle_label", sort=False):
axes[0].plot(group["valid_time"], group["precip_in_hr"], label=label, color=colors[label], linewidth=2)
axes[1].plot(group["valid_time"], group["flow_cfs"], label=label, color=colors[label], linewidth=2)
axes[2].plot(group["valid_time"], group["stage_ft"], label=label, color=colors[label], linewidth=2)
axes[0].set_title("Successive QPF Cycles: Basin-Average Rainfall Forecast")
axes[0].set_ylabel("Rainfall (in/hr)")
axes[0].legend(title="Forecast cycle", ncols=2)
axes[1].set_title("Routed Outlet Flow Forecasts")
axes[1].set_ylabel("Flow (cfs)")
axes[1].legend(title="Forecast cycle", ncols=2)
axes[2].axhline(config["action_stage_ft"], color="#8C8C8C", linestyle="--", linewidth=1.5, label="Action stage")
axes[2].axhline(config["flood_stage_ft"], color="#D62728", linestyle="--", linewidth=1.5, label="Flood stage")
axes[2].axhline(config["major_flood_stage_ft"], color="#7F0000", linestyle=":", linewidth=2, label="Major flood stage")
axes[2].set_title(f"Forecast Stage Response: {config['decision_point']}")
axes[2].set_ylabel(f"Stage ({config['stage_datum']})")
axes[2].set_xlabel("Valid time")
axes[2].legend(ncols=2)
for ax in axes:
ax.grid(True, alpha=0.3)
fig.autofmt_xdate()
fig.tight_layout()
plt.show()

fig, axes = plt.subplots(1, 2, figsize=(12, 4.5))
axes[0].bar(summary_df["label"], summary_df["peak_stage_ft"], color=[colors[x] for x in summary_df["label"]])
axes[0].axhline(config["flood_stage_ft"], color="#D62728", linestyle="--", label="Flood stage")
axes[0].set_title("Forecast Crest by Cycle")
axes[0].set_ylabel("Peak stage (ft)")
axes[0].tick_params(axis="x", rotation=30)
axes[0].legend()
for _, row in summary_df.iterrows():
axes[0].annotate(
f"{row['peak_stage_ft']:.1f} ft",
xy=(row['label'], row['peak_stage_ft']),
xytext=(0, 5),
textcoords="offset points",
ha="center",
fontsize=9,
)
axes[1].plot(summary_df["label"], summary_df["peak_stage_delta_vs_latest_ft"], marker="o", color="#222222", linewidth=2)
axes[1].axhline(0, color="#666666", linewidth=1)
axes[1].set_title("Convergence Toward 18z Latest Cycle")
axes[1].set_ylabel("Peak stage delta vs 18z latest (ft)")
axes[1].tick_params(axis="x", rotation=30)
axes[1].grid(True, alpha=0.3)
for _, row in summary_df.iterrows():
axes[1].annotate(
f"{row['peak_stage_delta_vs_latest_ft']:+.2f} ft",
xy=(row['label'], row['peak_stage_delta_vs_latest_ft']),
xytext=(0, 8 if row['peak_stage_delta_vs_latest_ft'] >= 0 else -14),
textcoords="offset points",
ha="center",
fontsize=9,
)
fig.tight_layout()
plt.show()
latest = summary_df.iloc[-1]
print("Operational interpretation:")
print(f" Decision point: {config['decision_point']}")
print(f" Latest cycle crest: {latest['peak_stage_ft']:.2f} {config['stage_datum']} at {latest['crest_time']:%Y-%m-%d %H:%M}")
print(f" Latest cycle peak flow: {latest['peak_flow_cfs']:,.0f} cfs")
print(f" Latest cycle flood exceedance duration: {latest['hours_above_flood']:.0f} hours")
print(f" Early-to-latest crest change: {summary_df.iloc[0]['peak_stage_delta_vs_latest_ft']:.2f} ft")
print(" Decision value: if the stage delta remains large, emergency managers should treat the forecast as uncertain and keep cycling until convergence improves.")

Operational interpretation:
Decision point: Bald Eagle Creek at Lock Haven forecast point
Latest cycle crest: 19.18 ft, local HEC-RAS project datum at 2024-07-15 18:00
Latest cycle peak flow: 11,428 cfs
Latest cycle flood exceedance duration: 9 hours
Early-to-latest crest change: -2.88 ft
Decision value: if the stage delta remains large, emergency managers should treat the forecast as uncertain and keep cycling until convergence improves.
Example 2: Automated Pipeline Template¶
This example provides a reusable function template for operational forecast cycling. The function encapsulates the full cycle workflow and can be called repeatedly as new forecast data becomes available.
Configurable Forecast Pipeline¶
def run_forecast_cycle(project_path, ras_version, plan_number,
forecast_date, forecast_cycle, forecast_hours,
archive_dir, basin_bounds=None, coastal_point=None,
execute_ras=False):
"""
Run or stage a single operational forecast cycle.
This function keeps the notebook safe by default (`execute_ras=False`).
In production, set `execute_ras=True` after the cycle-specific boundary
data have been written to DSS or the unsteady-flow file.
"""
cycle_start = datetime.strptime(forecast_date, "%Y%m%d").replace(hour=forecast_cycle)
cycle_end = cycle_start + timedelta(hours=forecast_hours)
cycle_label = f"{forecast_date}_{forecast_cycle:02d}z"
cycle_dir = archive_dir / cycle_label
result = {
"cycle_label": cycle_label,
"start": cycle_start,
"end": cycle_end,
"archive_dir": cycle_dir,
"status": "STAGED",
}
hrrr_dir = cycle_dir / "hrrr"
results_dir = cycle_dir / "results"
# Production hook 1: download HRRR forcing.
# grib_files = PrecipHrrr.download_forecast(
# output_dir=hrrr_dir,
# date=forecast_date,
# cycle=forecast_cycle,
# hours=forecast_hours,
# )
# Production hook 2: optional coastal downstream boundary.
if coastal_point:
stofs_dir = cycle_dir / "stofs3d"
# stofs_files = CoastalBoundary.download_stofs3d(stofs_dir)
# wse_df = CoastalBoundary.extract_wse_at_point(stofs_dir, coastal_point[0], coastal_point[1])
# CoastalBoundary.generate_stage_bc(wse_df, Path(project_path) / f"project.u{plan_number}", "Downstream")
result["coastal_boundary"] = "STAGED"
# Production hook 3: update dates and execute HEC-RAS.
if execute_ras:
init_ras_project(project_path, ras_version)
RasPlan.update_simulation_date(
plan_number,
start_date=cycle_start,
end_date=cycle_end,
)
compute_result = RasCmdr.compute_plan(plan_number, force_rerun=True)
result["status"] = "COMPUTED" if bool(compute_result) else "FAILED"
result["compute_result"] = compute_result
result["results_dir"] = results_dir
else:
result["status"] = "STAGED_RAS_READY"
return result
print("Forecast Pipeline Template Function")
print("=" * 72)
print("Use execute_ras=False for dry-run scheduling and execute_ras=True after cycle-specific boundaries are written.")
print("The hydrologic figures above provide the operational comparison; the production hook then computes the matching RAS plan.")
Forecast Pipeline Template Function
========================================================================
Use execute_ras=False for dry-run scheduling and execute_ras=True after cycle-specific boundaries are written.
The hydrologic figures above provide the operational comparison; the production hook then computes the matching RAS plan.
Running the Cycle Scheduler¶
The scheduler below uses the same cycle list that produced the hydrologic evidence. It creates RAS-ready metadata for each cycle without launching HEC-RAS in the documentation build. Set execute_ras=True in a real project workspace after the boundary data are written.
archive_dir = Path("forecast_archive")
all_results = []
print("Operational Forecast Schedule")
print("=" * 72)
for cycle_config in cycles:
result = run_forecast_cycle(
project_path=config["project_path"],
ras_version=config["ras_version"],
plan_number=config["plan_number"],
forecast_date=cycle_config["date"],
forecast_cycle=cycle_config["cycle"],
forecast_hours=config["forecast_hours"],
archive_dir=archive_dir,
basin_bounds=config["basin_bounds"],
execute_ras=False,
)
all_results.append(result)
print(f" {result['cycle_label']}: {result['status']} -> {result['archive_dir']}")
schedule_df = pd.DataFrame(all_results)
display(schedule_df[["cycle_label", "start", "end", "status", "archive_dir"]])
Operational Forecast Schedule
========================================================================
20240715_00z: STAGED_RAS_READY -> forecast_archive\20240715_00z
20240715_06z: STAGED_RAS_READY -> forecast_archive\20240715_06z
20240715_12z: STAGED_RAS_READY -> forecast_archive\20240715_12z
20240715_18z: STAGED_RAS_READY -> forecast_archive\20240715_18z
| cycle_label | start | end | status | archive_dir | |
|---|---|---|---|---|---|
| 0 | 20240715_00z | 2024-07-15 00:00:00 | 2024-07-16 12:00:00 | STAGED_RAS_READY | forecast_archive\20240715_00z |
| 1 | 20240715_06z | 2024-07-15 06:00:00 | 2024-07-16 18:00:00 | STAGED_RAS_READY | forecast_archive\20240715_06z |
| 2 | 20240715_12z | 2024-07-15 12:00:00 | 2024-07-17 00:00:00 | STAGED_RAS_READY | forecast_archive\20240715_12z |
| 3 | 20240715_18z | 2024-07-15 18:00:00 | 2024-07-17 06:00:00 | STAGED_RAS_READY | forecast_archive\20240715_18z |
Smart Skip for Unchanged Inputs¶
ras-commander's smart skip feature (force_rerun) is important in forecast cycling. Each new forecast cycle brings new precipitation data, so you always want fresh execution.
print("Smart Skip in Forecast Cycling:")
print("=" * 50)
print()
print("ras-commander's smart skip feature helps with forecast cycling:")
print()
print(" # Default behavior - skips if results are current")
print(" RasCmdr.compute_plan('01')")
print(" # -> 'Skipping plan 01: Results are current'")
print()
print(" # Force re-run for each new forecast cycle")
print(" RasCmdr.compute_plan('01', force_rerun=True)")
print(" # -> Always executes regardless of existing results")
print()
print("When to use each:")
print(" - force_rerun=True: Each forecast cycle (new data)")
print(" - force_rerun=False: Re-running analysis on existing results")
print(" - skip_existing=True: Simple existence check (legacy)")
Smart Skip in Forecast Cycling:
==================================================
ras-commander's smart skip feature helps with forecast cycling:
# Default behavior - skips if results are current
RasCmdr.compute_plan('01')
# -> 'Skipping plan 01: Results are current'
# Force re-run for each new forecast cycle
RasCmdr.compute_plan('01', force_rerun=True)
# -> Always executes regardless of existing results
When to use each:
- force_rerun=True: Each forecast cycle (new data)
- force_rerun=False: Re-running analysis on existing results
- skip_existing=True: Simple existence check (legacy)
Key Takeaways¶
Summary¶
Operational forecast cycling run summary:
- Download or stage new data each cycle (HRRR, STOFS-3D, USGS, HMS output, or another forcing source).
- Generate hydrologic evidence before the RAS run: QPF totals, routed hydrographs, crest estimates, threshold exceedance duration, and convergence against the latest cycle.
- Update plan dates to match the forecast window using
RasPlan.update_simulation_date(). - Execute with
force_rerun=Truebecause each cycle has new forcing data and must not reuse prior-cycle results. - Archive results by cycle for comparison, review, and emergency-management audit trails.
- Compare forecasts by hydraulic decision metric: peak WSE/stage, peak flow, flood-duration, arrival time, velocity/depth at critical locations, or inundation extent.
Best Practices¶
- Use
force_rerun=Truefor each new cycle; precipitation or boundary conditions changed. - Archive results with cycle-stamped directories before the next cycle overwrites them.
- Monitor forecast convergence across cycles. A large crest delta or crest-time shift is an operational uncertainty signal, not just a plotting artifact.
- Plot threshold exceedance, not just raw hydrographs. Action, flood, and major-flood thresholds make the result decision-relevant.
- Handle data latency: HRRR is typically available after cycle time; use
max_lookback_hourswithPrecipHrrr.get_latest_forecast()to find the most recent available cycle.
File Organization Pattern¶
forecast_archive/
├── 20240715_00z/
│ ├── hrrr/ # HRRR GRIB2 files
│ ├── stofs3d/ # STOFS-3D NetCDF files, if needed
│ └── results/ # HEC-RAS project copy with results
├── 20240715_06z/
│ ├── hrrr/
│ └── results/
├── 20240715_12z/
│ ├── hrrr/
│ └── results/
└── summary.csv # Cycle comparison table
Adapting for Your Project¶
- Replace
project_pathwith your HEC-RAS project location. - Set
basin_boundsto your watershed extent (west, south, east, north). - Replace the demonstration rainfall/runoff calculation with HRRR, HMS, or calibrated rainfall-runoff output.
- Add
coastal_pointif your model has a tidal downstream boundary. - Extract RAS results after each run and compare WSE, depth, velocity, or inundation where decisions are made.
import shutil
for folder_name in ["forecast_archive"]:
p = Path(folder_name)
if p.exists():
shutil.rmtree(p, ignore_errors=True)
print(f"Cleaned up: {folder_name}")
else:
print(f"Not found (nothing to clean): {folder_name}")
print("Done!")
Not found (nothing to clean): forecast_archive
Done!
